Haiyang Unit 2 enters commercial operation

Date:2019-01-10 Source:President's Office and International Affairs Author:Bao Li

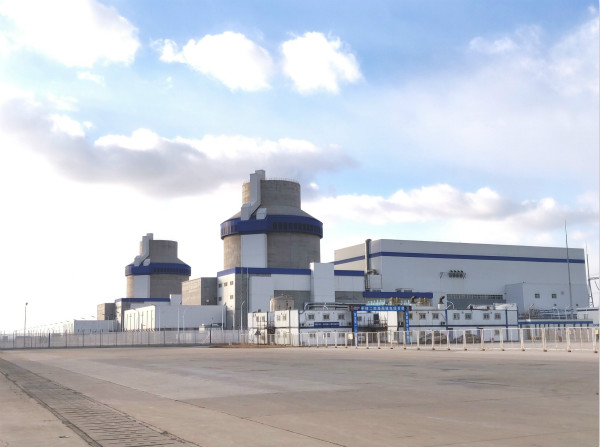

On January 10, 2019, Unit 2 of the Haiyang nuclear power plant in China's Shandong province has completed 168 hours of full-power continuous operation and is now deemed to be in commercial operation. It becomes the fourth AP1000 unit in China to reach the milestone.

20190109  海阳一期工程核岛照片_meitu_4.jpg

Construction of Sanmen 1, in Zhejiang Province, began in April 2009, while first concrete for Sanmen 2 was poured in December 2009. Construction of Haiyang 1 and 2 began in September 2009 and June 2010, respectively.

Sanmen 1 was the world's first AP1000 to start up, achieving first criticality - a sustained chain reaction - on 22 June last year and grid connection on 2 July. It reached full power operation for the first time on 14 August and entered commercial operation on 21 September.

Unit 1 of the Haiyang plant attained first criticality on 8 August and was grid connected on 17 August. That unit began commercial operation on 22 October.

Sanmen unit 2 attained first criticality on 17 August and was connected to the grid on 24 August. The reactor entered commercial operation on 5 November.

Haiyang 2 achieved first criticality on 29 September and was connected to the grid on 13 October.

Together, Haiyang units 1 and 2 will provide some 20 TWh of electricity to the grid annually, sufficient to meet one-third of household demand in Shandong province.

With the start of commercial operation of Haiyang 2, mainland China now has 46 power reactors in operation with a combined installed capacity of more than 45 GWe.
